Gov't, TEPCO set 40-yr work plan for scrapping Fukushima reactorsTOKYO, Dec. 21, Kyodo
The Japanese government and Tokyo Electric Power Co. said Wednesday they would seek to finish scrapping the four crippled nuclear reactors at the Fukushima Daiichi power plant in the next 30 to 40 years in a newly unveiled work schedule describing measures to be taken following the plant's stabilization.
Based on the road map toward decommissioning, the plant operator known as TEPCO would start removing the nuclear fuel stored in the spent fuel pools of the Nos. 1 to 4 units within two years and the melted fuel from the Nos. 1 to 3 reactors within 10 years.
A survey of the inside of the primary containment vessels of the reactors is expected around the latter half of fiscal 2017, and that of the reactor cores around fiscal 2020, government officials said. It is expected to bring to light what has happened inside the reactors in the world's worst nuclear crisis since the 1986 Chernobyl disaster.
english.kyodonews.jp by Edano 12/21/2011 12:46:28 PM


english.kyodonews.jp
Ministers Edano, Hosono at news conference
Japanese industry minister Yukio Edano (L) and nuclear disaster minister Goshi Hosono give a press conference at the Ministry of Economy, Trade and Industry in Tokyo on Dec. 21, 2011. The government and Tokyo Electric Power Co. said they would seek to finish scrapping the four crippled nuclear reactors at the Fukushima Daiichi power plant in the next 30 to 40 years in a road map toward decommissioning. (Kyodo) english.kyodonews.jp

@Pedro Jesus i think it's just a rough roadmap so far.
by Edano 12/21/2011 12:47:43 PM

Aomori municipalities call on gov't to maintain nuclear fuel recyclingTOKYO, Dec. 21, Kyodo
english.kyodonews.jp by Edano 12/21/2011 12:48:15 PM

Piles of tainted tree bark, woodchips left at Fukushima lumbermillsSENDAI, Dec. 21, Kyodo
At least 16,000 tons of radiation-contaminated tree bark and woodchips are piled up at lumbermills in Fukushima Prefecture, left unattended in storage in the aftermath of the nuclear crisis at a Tokyo Electric Power Co. plant, a local industry group said Wednesday.
The prefectural wood-industry association Fukushimaken Mokuren's roughly 200 member firms are in the process of requesting TEPCO by the year-end to compensate for such storage and disposal costs, which, unlike those for quake rubble, are not covered by state subsidies, it said.
The companies have stopped the shipment of bark and woodchips produced in the process of lumbering and used for compost or floors of livestock barns after radiation above the state-set limit was measured in the group's voluntary monitoring begun in August, it said.
english.kyodonews.jp by Edano 12/21/2011 12:49:32 PM

will do a look for the roadmap.
by lillymunster 12/21/2011 12:54:20 PM

Enviroment Pollution in USA on Wednesday, 21 December, 2011 at 04:09 (04:09 AM) UTC.Description
Radioactive material has been found in the groundwater around the Sequoyah Nuclear Power Plant. Tennessee Valley Authority officials have reported finding elevated levels of tritium in a groundwater sample taken from one of two new onsite monitoring wells at the Sequoyah Nuclear Plant. TVA says these elevated levels pose no threat to the health and safety of the public. "The newly installed groundwater monitoring wells were placed in an area known to have contained tritium that was previously reported," Sequoyah Plant Manager Paul Simmons said. "The health and safety of the public are our primary concern, which is why providing additional monitoring capability to the plant's groundwater wells is an important measure for protecting the community and the environment." There are a total of 16 groundwater monitoring wells on the Sequoyah site. The highest level found in the sampling on Friday, December 16, was approximately 23,000 picocuries per liter. A "curie" is the standard measure for the intensity of radioactivity contained in a sample; a picocurie is one trillionth of a curie.
None of the Sequoyah groundwater monitoring wells is used for drinking water or irrigation purposes and no potable water wells are downstream of where the tritium was found. Additionally, TVA confirmed no detectable levels of tritium in any sampling of the Tennessee River where the plant discharges water. "Sequoyah voluntarily communicated to federal, state and local officials these elevated sample results due to TVA's own conservative decision-making process and in accordance with a groundwater protection initiative established by the nuclear industry in 2006, " Simmons said. "TVA is reviewing the new monitoring well sample results, determining the cause of these elevated levels and how they relate to the previously reported releases of tritium." An Associated Press investigation published earlier this year found tritium leaks at 75 percent of the commercial nuclear power plants in the United States. The number and severity of the leaks has been escalating, even as federal regulators extend the licenses of more and more reactors across the nation. Tritium, which is a radioactive form of hydrogen, has leaked from at least 48 of 65 sites, according to U.S. Nuclear Regulatory Commission records reviewed as part of the AP's yearlong examination of safety issues at aging nuclear power plants. Leaks from at least 37 of those facilities contained concentrations exceeding the federal drinking water standard - sometimes at hundreds of times the limit.
hisz.rsoe.hu by Edano 12/21/2011 12:56:11 PM

This appears to be the version in EN, "digest" version.
www.meti.go.jpby lillymunster 12/21/2011 12:57:13 PM

On the seal outbreak, the Atlantic outbreak was determined to be a virus. All current marine mammal outbreaks have identified or likely causes except the one spreading from Russia to Alaska.
by lillymunster 12/21/2011 1:03:42 PM

Reading the METI roadmap. 2-10 years to empty spent fuel pools. Continued cooling of the reactors is in the 2-10 year plant. That is going to be a massive amount of leaky water to handle. With TEPCO already wanting to dump more in the Pacific I can see this being a huge ongoing problem. They want to start removing fuel within 10 years but have to decontaminate buildings first. How are they going to decontaminate them? Power washing? Is that going to run off too?
by lillymunster 12/21/2011 2:27:27 PM

another admission the treated water only has cesium removed.
" By 2012, new decontaminated water processing facilities against multi-radioactive nuclides,which can not be removed by existing Cesium treatment facilities, will be installed."
by lillymunster 12/21/2011 2:34:03 PM

They also plan to dredge the harbor and pile up the contaminated silt and sand in front of the intakes. They claim this will keep more from leaking out the intakes and prevent it from coming out of the soil.
by lillymunster 12/21/2011 2:39:36 PM

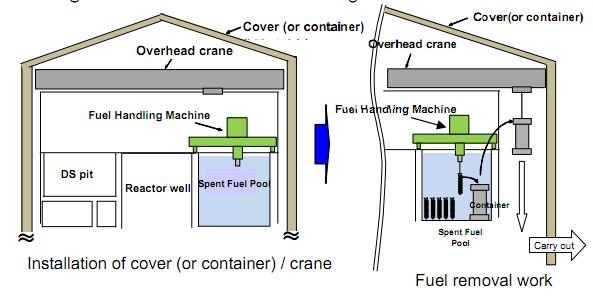

Fuel removal plan
by lillymunster 12/21/2011 2:42:42 PM

A couple of things in that illustration do not make sense. The crane is show running the long ways north-south above the reactor refueling floor. The overhead cranes that existed in the buildings run the other direction, east-west in the buildings. Of course 1, 3 and 4 can no longer make their overhead cranes function for obvious reasons. So this appears to be some sort of new crane installed for retrieving fuel. What are they going to install it to? Do the metal frameworks of the covers really have the ability to support a huge metal overhead crane? I am guessing they don't even with the expanded steel framework they used. So I am not sure how they pull this one off unless the framework was designed with the plan to put in an overhead crane and they are stronger than they appear?
by lillymunster 12/21/2011 2:47:54 PM
